PSA Software: What It Is and How to Choose One for an Agency
PSA software, short for professional services automation software, connects client projects with the people, time and money needed to deliver them. A service business uses it to plan work, record hours, track costs and understand project profitability. Some systems also cover sales, quotes,…

PSA software, short for professional services automation software, connects client projects with the people, time and money needed to deliver them. A service business uses it to plan work, record hours, track costs and understand project profitability. Some systems also cover sales, quotes, invoicing and recurring client work.
The project manager sees completed tasks, the finance team sees payments, and the owner wants to know whether the remaining budget will cover the unfinished work. Answering that question means reconciling several spreadsheets. PSA brings those records together so the team can review costs while there is still time to act.
This guide explains what PSA software does and compares eight systems for agencies, studios and other service businesses. We focus on choosing a workable setup, including the plan and modules required. if.team publishes the guide and is assessed alongside the other products. Public product and pricing pages were checked on 15 November 2026; the comparison is based on documentation rather than hands-on tests of every platform.
What is PSA software used for?
A service business sells work performed by people. To estimate the result of a project, it needs more than a task count: the agreed fee, hours already used, rates, contractor costs and the effort still required.
A PSA system connects those records. A change to the delivery plan can then inform the cost forecast, provided the estimates and rates are maintained. The specific calculation and included modules vary by product. SAP’s PSA overview provides another explanation of the category and its core capabilities.
A simple project example
A hypothetical studio agrees a $10,000 fee. Its delivery plan contains 160 hours at an average internal cost of $35 per hour, plus $1,000 in contractor costs.
Planned direct cost is $6,600: 160 × $35 + $1,000. That leaves $3,400, or 34% of the fee, before company overhead and taxes. This is a simplified project margin, not the company’s net profit.
During delivery, the team has logged 90 hours and estimates that another 100 are needed. The updated direct-cost forecast is $7,650: 190 × $35 + $1,000. The remaining margin is $2,350, or 23.5%. Those extra 30 hours add $1,050 in direct cost at the same rate.
What changed? Did the estimate miss part of the work? Did the client add scope? Does the team need more revisions than expected? A connected project record lets the manager investigate before the fee has been consumed.
The manager updates the remaining estimates so the forecast includes the extra 30 hours.

With the project fee unchanged, 30 extra hours reduce margin from 34% to 23.5%.
Project management software for professional services: PSA, task trackers and ERP
| Type of system | Main question | Typical scope | What to verify |
|---|---|---|---|
| Task tracker | Who is doing what, and by when? | Tasks, statuses, deadlines and collaboration | Whether financial figures are calculated or merely stored |
| PSA | Can we deliver client work with the people and budget available? | Projects, time, resources, costs and billing workflows | The modules included and how forecasts are calculated |
| Accounting software | How should transactions be recorded and reported? | Books, financial reporting and jurisdiction-specific accounting | The connection between project operations and statutory records |
| ERP | How are the company’s wider resources and processes managed? | Scope varies: finance, procurement, inventory, HR, projects and more | Whether service delivery is supported in enough detail |
These categories overlap. A PSA may include company financial reports, and an ERP may include strong project management. Judge the workflows you need rather than the label.
PSA also means different things in different service markets. An MSP may prioritize tickets, service-level agreements and recurring support contracts. A design studio may prioritize project fees, revisions and staff availability. This comparison focuses on project-based services, not a help-desk-led MSP shortlist.
When an agency needs PSA
If the immediate problem is organizing tasks and conversations, consider the simpler tools in our Basecamp alternatives comparison. Moving to PSA should address a specific need to connect delivery with people, time and financial records.
Consider a connected system when managers repeatedly reconcile hours and costs across files, cannot assess the margin on active work or allocate the same specialists to overlapping projects.
A simpler setup may still be enough if a small team has a few straightforward engagements and can answer those questions reliably. Moving to PSA creates work of its own: maintaining rates, classifying expenses, recording hours and agreeing access permissions.
Before evaluating vendors, write down three questions the new system must answer. For example: “Which projects are likely to exceed their labor budgets?”, “Can we accept another website next month?” and “Which approved hours have not been invoiced?” These questions produce a more useful demo than a request to show every feature.
Match PSA software to your billing model
Two projects with the same tasks can need different financial rules. One sells an agreed result for a fixed fee, another bills hours, and a third provides a monthly package of services. Test the system against your model, including what happens when the engagement changes.
Fixed-fee projects: monitor the cost to finish
In the website example, the fee remains $10,000 even if delivery takes longer. The manager therefore needs actual costs together with an estimate of the remaining work. The manager then decides who does the extra work, on what terms and at what cost.
Keep the original estimate, current forecast and approved fee change separate. Extra forecast hours should not automatically become money owed by the client. Until the additional scope and price are agreed, they primarily change expected delivery cost.
Ask the vendor to demonstrate two cases: an internal underestimate and extra pages requested by the client. Can the manager distinguish them in reporting? Does the original agreement remain available after the task estimates change?
Time and materials: check rates, approval and limits
Hourly delivery needs both an internal cost rate and a client billing rate. They are different figures. Ten illustrative hours sold at $60 generate $600 to invoice if all ten are approved as billable. At an internal cost of $35 per hour, the same work costs $350.
The $250 difference is before other costs. If some hours cannot be billed, the outcome changes. The system should let the team distinguish billable, non-billable and unapproved records and understand how corrections are handled.
Add an engagement limit to the test. Suppose the client has approved no more than forty hours without further authorization. Check how the manager notices the approaching limit and records approval for extra work. A cap on an invoice does not necessarily prevent people from continuing to work.
Retainers: define the period and the allowance
A monthly retainer might buy availability, a bank of hours or a defined set of deliverables. Establish how unused allowances, overages and additional requests work. The configuration needs to reflect that agreement.
During the demonstration, cross a month-end with five unused hours, an unfinished task and a new request. Check which period receives the hours and costs. A single perpetual project without period-level review can hide an unprofitable month inside the overall total.
Products implement these models differently. For example, Productive’s billing documentation distinguishes Fixed, Time and Materials, and Non-billable services. Those are one product’s rules; confirm terminology and calculations for each shortlisted system.
How to choose PSA software for agencies: six practical checks
1. Trace a number back to its records
Ask the vendor to open a project margin figure and show the hours, rates and expenses behind it. Check what changes when someone edits an estimate, records time late or changes a rate.
A dashboard is only useful if the team understands the calculation. Agree whether the number represents revenue, cash received, planned fees or another basis.
2. Test your pricing model
Bring a fixed-fee project, a time-and-materials engagement or a retainer—whichever you actually sell. Check scope changes, recurring work, billable and non-billable time, and how the final invoice is prepared.
Test the full path from a time entry to the amount billed.
3. Check resources across projects
In if.team, use the Work Calendar for planned hours and the Workload timesheet for recorded time. Logged hours alone do not show all future commitments.
Plan the same specialist on two engagements. Include leave and internal work. Can the manager see the conflict and understand the available hours?

The calendar helps account for working days and absences when planning capacity.
4. Follow a sale into delivery
If sales and delivery use different tools, check how the approved scope, client, fee and estimates move between them. A native CRM is not essential if the integration is reliable, but responsibilities must be clear.
Ask what happens after the quote changes. Does the delivery plan update, or does someone need to reconcile it manually?
5. Check financial access and exports
A project manager may need project costs without access to everyone’s pay. A client may need progress without internal rates. Test those roles using sample accounts.
Verify what can be exported and how accounting records are synchronized. A claim that a product “integrates with accounting” does not explain which objects, currencies and corrections it supports.
6. Price the workflow, not the cheapest plan
Include required modules, minimum seats, onboarding, integrations and client access. Record both the subscription and the internal time needed to maintain it.
Ask for a quote on a concrete configuration: twenty employees, five external reviewers, fixed-fee projects, resource planning and a connection to your accounting system.
Professional services automation software comparison
In our example, the system must connect the agreed fee, recorded hours and revised remaining work. The table shows how each product approaches that workflow and where its package boundaries lie.
| System | What it connects | A distinction that affects the choice |
|---|---|---|
| Scoro | Projects, time, resources, estimates and billing through separate apps | Projects & Resources and Quote to Cash cover different workflows; End-to-end combines the full set |
| Productive | Budgets, time, expenses and resources in Essential | Recurring budgets require Professional; Revenue forecasting and Scenario Builder require Ultimate |
| Teamwork | Client projects and billable delivery | Basics covers time, Accelerate time budgets, and Optimize financial budgets and forecasting |
| Accelo | Sales, one-off projects and ongoing client service | Fixed-fee projects and retainers can run together; pricing is tailored |
| BigTime | Time records, expenses and invoicing | Premier adds budgets and rate controls; Quotes and Resource Management are additional modules |
| Kantata | Staffing, delivery and financial forecasting | Deployment and integrations need an agreed scope; pricing is customized |
| Birdview PSA | Projects, time, budgets, expenses and billing | Team shows workload; Enterprise adds resource allocations |
| if.team | Tasks, hours, rates, payments and cost forecasts | Packages limit team size; Quotes and Automations are separate modules |
Scoro: assemble the workflows you need
Scoro uses separate apps. Projects & Resources connects delivery with staffing; Quote to Cash connects estimates, delivery, time and invoicing. Choose the combination that covers your workflow.
A studio with an established CRM can start with the workflow it needs. A company moving the whole client lifecycle should consider End-to-end or a tailored combination. Package contents.
Productive: project budgets and recurring work
Essential covers the basic records in our example: budgets, hours, expenses and resources. Professional adds recurring budgets for agencies managing ongoing client work. Revenue forecasting and Scenario Builder belong to Ultimate.
Sales is also built in: Essential supports one pipeline, Professional three and Ultimate five. Those are concrete boundaries for a company with several sales processes. Pricing and pipeline documentation.
Teamwork: expand the controls as requirements grow
Teamwork progresses from tasks and billable hours to time budgets, planning and financial control. Those capabilities are separated across Basics, Accelerate and Optimize.
For hourly work, time records and invoicing may meet the main need. For a fixed-fee website where profitability forecasting matters, Optimize is the relevant comparison. Choose the tier around the required outcome. Pricing and features.
Accelo: combine projects with ongoing client service
An agency may build a fixed-fee website while maintaining other clients’ sites each month. Those engagements have different scope and billing agreements. Accelo supports one-off projects and retainers in the same environment.
Its sales record links quotes, projects and communication history, making it relevant when agreements need to survive the handover from sales to delivery. Pricing is tailored; the proposal needs to cover the intended workflows and implementation. Buying information and sales-record documentation.
BigTime: connect recorded work with invoicing
BigTime starts with time, expenses and invoicing. That makes it relevant to a firm losing billable hours between delivery and the client invoice.
Premier adds project budgeting and rate management. Quoting and resource planning extend through Quotes and Resource Management. Price Premier together with the add-ons your team needs. Plans and modules.
Kantata: align staffing and financial plans
When several managers need the same specialists, resource planning becomes central to the PSA decision. Kantata connects that area with delivery and financial forecasting.
Such a rollout needs defined connections to existing systems and someone responsible for maintaining the model. Ask the vendor for a quote based on your team size and required workflows. Product and pricing approach.
Birdview PSA: distinguish workload from allocations
Team includes time, budgets, expenses, invoicing and workload visibility. Enterprise adds resource allocations.
That distinction matters if a manager needs to reserve a specialist’s future participation in a project. Seeing scheduled work and making separate resource allocations are different requirements. Pricing and features.
if.team: connect a task with the cost forecast
if.team charges per company, with a team-size limit for each plan. Basic costs $70/month for up to ten people. Adding a colleague within that limit keeps the subscription at $70; Quotes and Automations each cost an additional $19/month.
In the opening example, extra hours increased the project’s expected cost. In if.team, that calculation uses tasks, rates and planned payments, while CRM and chats preserve the client context.
Choose the package by team size and storage, then add optional modules as needed. Its calculation rules and integrations still need to match the company’s management-accounting process. Product and pricing.
How much does PSA software cost?
The required workflow determines the relevant price. Recording hours may need only an entry package; resource planning, recurring budgets or revenue forecasting may require a higher tier. These public prices are in USD and exclude taxes, migration and additional integrations.
| System | Public price | What affects the choice |
|---|---|---|
| Scoro | Time-billing from $17/user/month; Projects & Resources and Quote to Cash $29; End-to-end $57 | Five-user minimum; these are different app combinations, with extras priced separately |
| Productive | Essential $10/user/month billed annually or $12 billed monthly | Three-seat minimum; Professional is $25 with annual billing, Ultimate is custom-priced |
| Teamwork | Basics $9.99 and Accelerate $24.99/user/month, billed annually | Financial budgets and forecasting require a custom-priced Optimize plan |
| Accelo | Custom quote | Team, workflows and implementation |
| BigTime | Essentials from $20/user/month | Budgets require Premier; resource planning and Quotes are separate modules |
| Kantata | Custom quote | Company size, configuration and implementation |
| Birdview PSA | Team special price $37/user/month billed annually; listed regular price $41 | Allocations require Enterprise; pricing varies by volume and license type |
| if.team | $30/company/month for three people; $70 for ten; $175 for twenty-five; $350 for fifty | Quotes and Automations each add $19/month |
For ten employees, Productive Essential costs $100/month equivalent, or $1,200 paid annually; monthly billing costs $120/month. if.team Basic costs $70/company/month, or $89 with Quotes. Birdview PSA Team at the promotional rate is $370/month equivalent, or $4,440 paid annually.
Requiring revenue forecasting or resource allocations can move the purchase to a higher plan. Compare final proposals against the same workflow requirements.
For a first-year budget, add subscription fees, modules, migration, integration setup and training. Estimate internal staff time separately: someone must validate rates, transfer active work and support adoption. Official sources are linked in the reviews above; promotional and contractual terms belong in the vendor’s proposal.
Best PSA software for small and mid-sized agencies: how to make a shortlist
For a team of ten to fifty, keep two or three products based on the requirement that makes the move worthwhile:
- For hours, expenses and budgets on one-off projects, start with Productive Essential and if.team; in Scoro, identify the relevant apps.
- For billable hours and invoicing, compare Teamwork Accelerate, BigTime and Scoro Time-billing. A financial forecast may require a different package.
- For ongoing client service alongside one-off projects, consider Accelo and Productive Professional. If resource allocations are the main requirement, compare the relevant Kantata capabilities with Birdview Enterprise.
Give each shortlisted vendor the same project, the same rates and the same scope change so you can compare the results. Keep only systems that let the responsible people explain the resulting numbers.
A smaller company should also name the person who will maintain the setup. A sophisticated configuration without an owner becomes another source of inconsistent data.
Which PSA metrics should you review after implementation?
Start with a few measures the team uses to make decisions. For each, define the records included, the period, the person responsible for updates and the action to take when the result changes.
Forecast cost at completion
In our simplified example, forecast cost combines actual costs with the estimated cost of remaining work. The hours are ninety already recorded plus one hundred still expected, giving 190. Adding all 190 to the ninety actual hours would count completed effort twice.
Check what an estimate field means in the selected tool: total planned effort or remaining effort only. Apply the same discipline to contractor expenses and future payments. One contractor cost should not enter the forecast both as an incurred expense and as a second piece of future work.
In if.team, the forecast uses unused planned task hours and scheduled payments. The project financial planning documentation explains the inputs and displayed measures.
Project margin and cash timing
For the worked example, we subtract direct costs from the agreed fee: $10,000 − $7,650 = $2,350. Dividing that balance by $10,000 gives 23.5%. This is a management calculation, not an accounting measure.
If the client has paid only a deposit, the agreed fee is unchanged, but the cash available for payments is different. A project can have a positive expected margin and still require funding before the next client payment arrives.
Review payment timing alongside margin. For company-level results, account for shared operating costs separately. Avoid deducting them twice if the internal hourly cost already includes an overhead allocation.
Utilization and billable work
Utilization compares work with a time base, so the denominator matters. Suppose a person has 32 available hours after leave and non-working days, with 24 billable client hours. On that basis, billable utilization is 24 ÷ 32 = 75%.
That is not a quality score. The remaining hours may support training, sales, internal assistance or management. Compare like roles under consistent definitions rather than setting the same percentage for a designer and a department lead.
Keep planned and actual utilization separate. You may book 24 billable hours for next week, while the eventual time records show a different result. Productive’s availability guide gives one documented definition and calculation; other systems may use different inputs.

The 190-hour forecast includes ninety completed hours and one hundred remaining hours; it is not added on top of actual effort.
A practical PSA workflow in if.team
The screenshots below show the interface with separate demo data.
Let’s test the chosen system with the $10,000 website example from the start of this guide. Here is the information if.team needs so the manager can see the overrun and decide what to do.
Carry the agreed scope into a project
Record the inquiry and client in CRM. When the work is agreed, create the project from the lead and review the prefilled client and budget. Relevant preparation tasks and their recorded time can be transferred. The Lead Card documentation explains how to convert a lead into a project.

The lead list shows expected budgets, statuses and the people responsible for each inquiry.
Enter the work and cost assumptions
Create tasks with planned hours and assignees. Check the internal rates and add the planned contractor payment. Confirm the project’s calculation method before interpreting its profit figure.
The example’s $35 is a simplified average cost. In actual use, rates can differ by person, and the treatment of overhead needs an agreed policy.

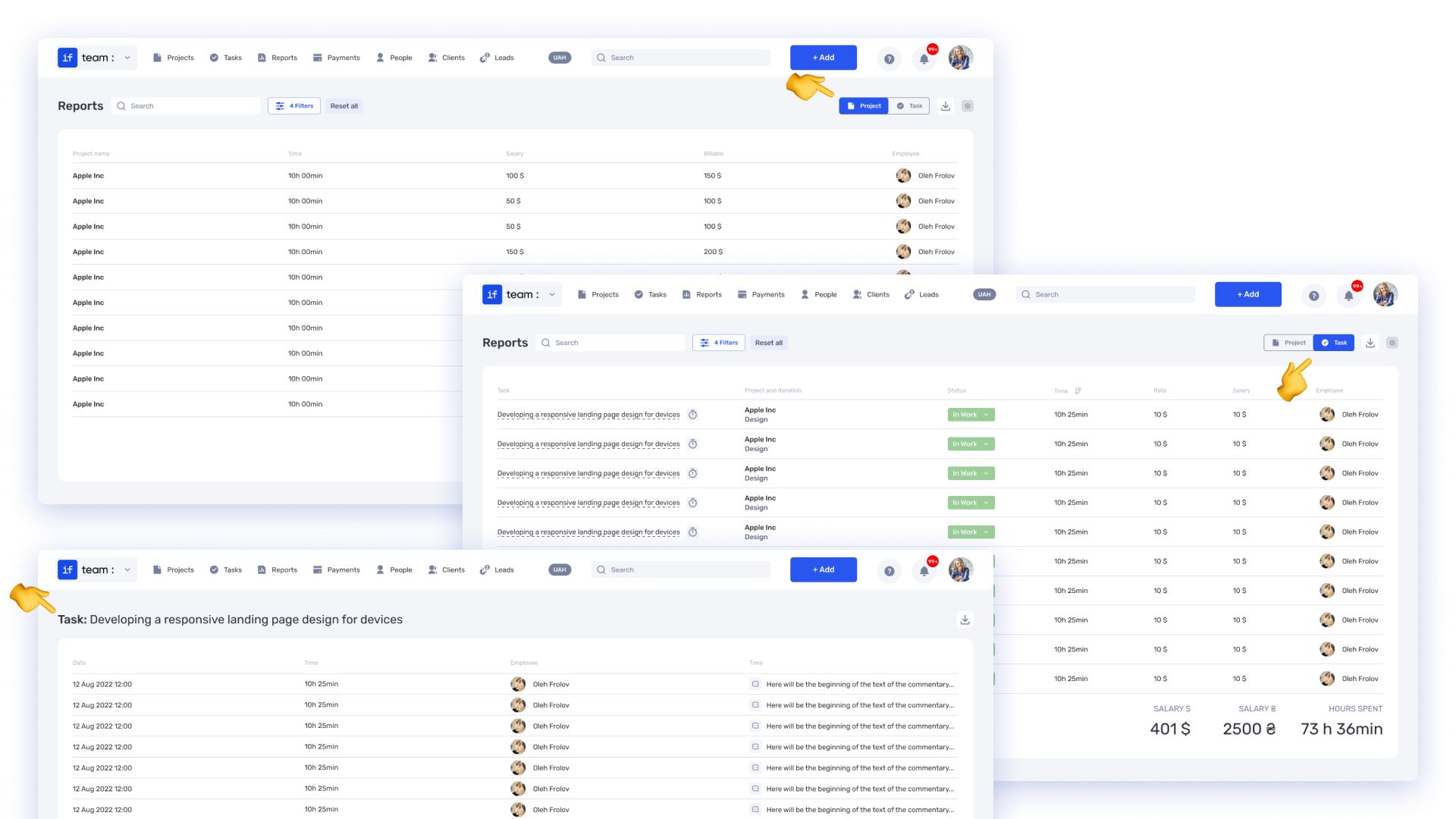

The task report brings recorded time, planned hours and labor costs together.
Check the forecast, then update remaining work
In the project’s financial section, select Planning. Forecast figures appear alongside actual figures, using unused planned task hours, assignee rates and scheduled payments.
In our example, the team has logged 90 hours. The original 160-hour estimate leaves 70, but the team now expects to need another 100. Update the affected task estimates so the total plan accounts for 190 hours. Compare the expected cost with the manual calculation: $7,650 under the example’s assumptions.
The chart uses solid lines for actual figures and dashed lines for forecasts. Hover over a date to inspect the amounts, or select an iteration to review one stage. Each metric’s tooltip explains its calculation. See the project financial planning guide for the details.

The financial view compares the demo project’s actual and forecast costs, with a breakdown for a selected date.
Review the cause with the project manager
Open the tasks behind the cost increase. The same 30 extra hours can require different decisions.
| Cause | The manager’s next step |
|---|---|
| The client requests pages outside the agreed scope | Estimate the extra work and agree its price and timing before proceeding |
| The team underestimated the agreed work | Update the forecast, establish a workable completion plan and use the error to improve future estimates |
| An error requires rework | Investigate the cause and plan the correction; an overrun does not automatically justify an extra client charge |
The extra $1,050 in our example is an internal delivery cost, not a ready-made client price. Any change to the commercial agreement needs to be agreed separately.
Record the decision and update the estimates. At the next review, the manager should see the revised plan and who is responsible for carrying it out.
Company financial reports answer a broader question than this project margin. See financial management for the relationship between project data, payments and company reporting.
How to tell whether PSA implementation worked
Before the move, record the activity you want to improve. A manager might assemble a project forecast from three files every Friday. After the pilot, check whether they can obtain the equivalent answer from the system, explain it and identify records needing attention.
Do not stop at the presence of a dashboard. Take one completed project and one active engagement. Reconcile rates, hours, expenses and remaining work against a control calculation. Even a small difference needs an explanation: rounding, mismatched periods and duplicate records have different implications.
Assign owners for the data. An assignee records time, the project manager updates remaining work, and the finance owner checks rates and expenses. If everyone is responsible, missing records stay unresolved.
During the first delivery cycles, examine exceptions: a task without an estimate, an expense without a project, a mid-project rate change or a late time entry. Record the correction rule and check whether another person can follow it.
Useful implementation lets the team notice changes earlier and name the resulting action. It might agree on additional pages before building them, move an assignment before overloading someone, or revise an estimate before the budget runs out. Compare those outcomes with your own starting process rather than assuming a universal savings percentage.
For a growing agency, also check whether the process survives a new manager or a second team. The forecast should not depend on one administrator privately remembering which entries to fix before every report. Reliable routines matter as much as the initial configuration.
How to move to PSA without recreating the same problems
First, agree what counts as billable work, which rate represents internal cost and who updates estimates. A shared time-tracking process helps make those records consistent. Then configure one project with clean data.
Run a pilot that includes a scope change, an expense and a review of the financial result. Reconcile that result against a calculation the finance owner understands. Check employee and client permissions before inviting the wider team.
Migrate active work after the pilot. Keep an accessible archive rather than importing years of inconsistent records into the new system. Agree a cutover date and a regular review of missing hours, uncategorized expenses and outdated estimates.
Binary Future’s case describes a move from ClickUp motivated by project financial visibility.
To evaluate if.team, start a trial or book a demo using one of your projects.
Frequently asked questions
What is PSA software?
Professional services automation software connects project delivery with time, people, costs and financial workflows. Its purpose is to help a service business plan work and understand the result of delivering it.
What is the difference between PSA and ERP?
PSA focuses on delivering services. ERP can cover a wider set of company processes, such as procurement, inventory and finance. The categories overlap, so compare the actual workflows and reporting.
How do small agencies and mid-sized firms choose PSA software?
Choose a few systems that support your pricing model and required financial view, then test them with the same project. Include the cost and effort of maintaining the data.
Is there free PSA software?
Some vendors, such as Teamwork.com, offer limited free project-management plans. A free plan does not necessarily include the full PSA financial workflow. Other vendors offer trials or sales demonstrations.
Does PSA replace accounting software?
Not automatically. A PSA may manage operational financial records and reports, but statutory accounting, tax reporting and integrations need to be checked for the company’s jurisdiction and process.
How much does PSA cost?
For ten people, Productive Essential is $100/month equivalent with annual billing or $120 billed monthly; if.team Basic is $70/month for the company, covering up to ten people. There is no extra per-user charge within that limit; optional modules cost extra. Several products use custom quotes. Implementation, integrations and the required higher-tier features can change the total.
How is PSA for agencies different from PSA for MSPs?
An agency usually needs project delivery, staffing, fees and margins. An MSP may place greater weight on support tickets, service contracts and SLAs. Select the shortlist around those different workflows.
Author
Vladyslav ChesnokovPublished
May 16, 2025
More articles to read

What Is a Kanban Board? Definition, Examples, Setup
A Kanban board is a visual workflow tool that represents work as cards moving through columns. The columns show each stage of the process, while work-in-progress limits control how many items a team handles at once. The board makes blocked work, queues, and delays visible.

RACI Matrix: Definition, Free Template and Example
A RACI matrix is a table that shows who does the work on a project, who accepts the result, who gives input, and who gets updates. The name comes from the four roles: Responsible, Accountable, Consulted, Informed. Rows are deliverables or decisions, columns are people or roles.

Agile Methodology: What It Is, Principles, Example
Agile methodology is an approach to project management in which a team delivers results in short cycles, shows them to the client and adjusts the plan based on feedback. Instead of one big six-month plan, agile project management works in a series of small, tested steps.

What is a deadline? How to set and meet realistic deadlines
Why six hours of work can take several days—and how to build a schedule around availability, review, and revisions. With a practical if.team walkthrough.

ERP systems explained—what they do and when your business needs one
See how ERP connects sales, delivery, and finances, with a worked example and a practical walkthrough in if.team.

Project time tracking — how to track team hours and costs
A practical guide to recording project hours, understanding overruns, and calculating team costs, with a worked example and a walkthrough in if.team.
See if.team in action for your company
We’ll show how projects, team time and finances connect in one system, using your processes as an example.
